Quality of Service (QoS) Standards for NetLink Trust's Fibre Connection Services for the Apr – Jun 2019 Quarter

NetLink Trust's QoS Performance for Installation-Related Service Levels

Percentage of Residential End-User Connections Delivered to NetLink Trust's Requesting Licensees in Working Condition

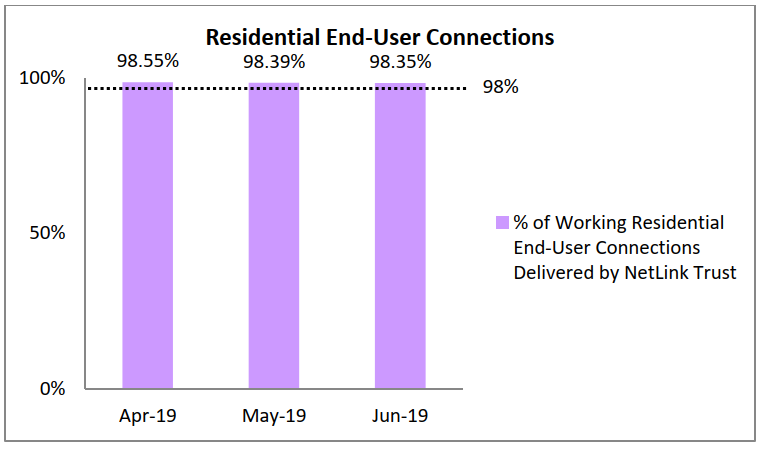

Residential End-User Connections

Percentage of Non-Residential End-User Connections Delivered to NetLink Trust's Requesting Licensees in Working Condition

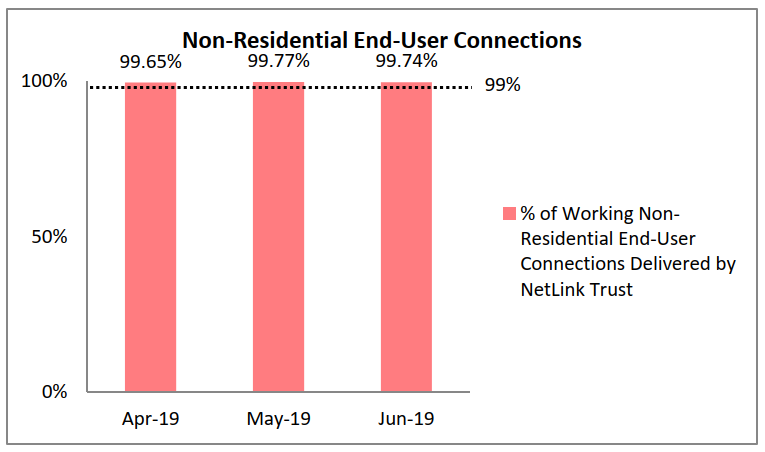

Non-Residential End-User Connections

NetLink Trust's QoS Performance for Timeframe in the Provisioning of End-User Connection Services

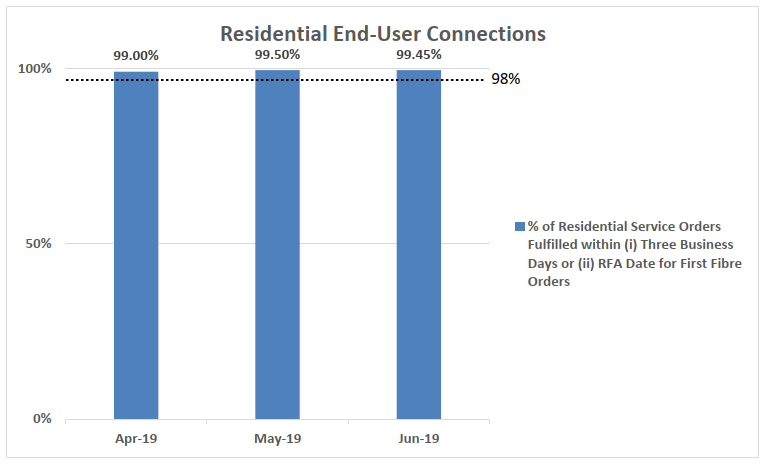

1. Percentage of Residential Service Orders Fulfilled within (i) Three Business Days of the Date of the Service Order or (ii) by Request For Activation ("RFA") Date for First Fibre Orders

Q2 2019 Non Residential End User Connection

When both first and second fibre orders are aggregated together, between April to June 2019, NetLink Trust has fulfilled 95.73% to 97.00% of orders within three business days or RFA date, and 97.88% to 98.47% of orders within seven business days or RFA date + 4 business days.

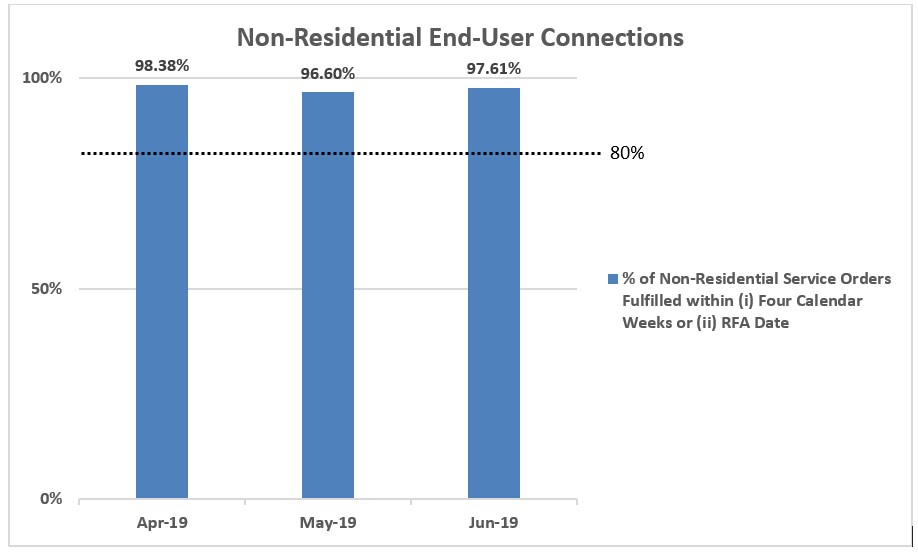

2. Percentage of Non-Residential Service Orders Fulfilled within Four Calendar Weeks from the Date of the Service Order

NetLink Trust has fulfilled 99.20% to 99.46% of orders within eight calendar weeks or RFA date + 4 calendar weeks in April to June 2019.
